your commute to HITEC City and Financial District is just a 15 to 17 minute drive on the Nehru outer ring road
Sprawled across 25 acres, this vibrant gated community offers 14 towers in total, 13 of which have already been delivered. PBEL CITY located away from the city but still near everything important.
Every floor has early warning fire measures like hand-held extinguishers and water hoses.
In case a fire is too intense for early warning fire measures, follow the exit signs and evacuate the building.
A pressurized network of pipes feed the fire sprinklers in every room of your house.
Every fire sprinkler has a temperature activated glass bulb that melts at 68° Celsius.
Only the fire sprinklers in the region of the fire will activate when a fire melts the glass bulbs.
Temperature Activated Sprinkler
Three redundant water pumps activate in sequence when they sense a drop in water pressure. This ensures the sprinklers are fed with a constant water pressure.
Pump 1 is an electric pump capable of delivering 180 litres per minute.
Pump 2 is a high capacity electric pump which can deliver up to 2250 or 2850 litres per minute, depending on the height of the building. This pump switches on if Pump 1 is unable to maintain water pressure.
Pump 3 is a high capacity diesel pump which can also deliver up to 2250 or 2850 litres per minute, depending on the height of the building.
This diesel pump switches on if Pump 1 and 2 are unable to maintain water pressure or if the electrical power supply fails.
68°celsius
will melt the temperature activated glass bulb and active the sprinkler.
Engineering
The engineering that ensures your water comes to you at the right quality and pressure.
Treatment and reuse of Sewage Water drops the overall quantity of water needed by a factor of 40.9%.
Metered water usage on an apartment level reduces water consumption patterns.
Low flow, water-efficient fixtures imitate the flow characteristics of regular fixtures while using 30% less water.
Pneumatic Booster Pumps actively boost water pressure to the upper floors.
Pressure Reducing Valves are passive mechanisms that reduce water pressure across lower floors.
Pressure Reducing Valve
Construction
Updates
September 2023
August 2023
July 2023
June 2023
May 2023
April 2023
March 2023
February 2023
January 2023
December 2022
November 2022
October 2022
September 2022
August 2022
July 2022
June 2022
May 2022
April 2022
March 2022
February 2022
January 2022
December 2021
November 2021
October 2021
September 2021
August 2021
July 2021
June 2021
May 2021
April 2021
March 2021
February 2021
January 2021
December 2020
November 2020
October 2020
September 2020
August 2020
July 2020
June 2020
May 2020
April 2020
March 2020
February 2020
January 2020
Tower M
Lakeside
TS RERA Number: P02400001909
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.

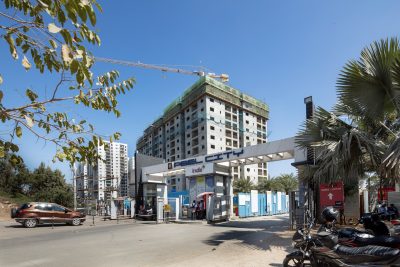

Tower M update
External paint completed alongwith the lobby marble polishing works, DG room fabrication works and the north side exit gate works. In progress are works related to the main door polishing (above 19th floor), 2nd coat paint (completed up to 18th floor), electrical wiring and CP & Sanitary fixing (done till the 17th floor).
TS RERA Number: P02400003490
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Lakeside Update
Structure completed till the 28th floor. In progress are different works related to balconies & utilities railing (at the 25th floor), door frames fixing (at the 21st floor), UPVC windows fixing (at the 7th floor), apartment & corridor putty (at the 17th floor), inside apartment tiling (at the 19th and 20th floor) and fire fighting testing works (at the 24th floor). For the mock-up apartment, all interior (wood work) and final painting works are completed.
Lakeside
Tower M
Tower N
TS RERA Number: P02400003490
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Lakeside Update
Structure completed till the 26th floor. Putty works are in progress on the 13th and 14th floors along with toilet dado & internal apartment tiling on the 17th floor. The fire fighting works are in progress on the 23rd floor.
TS RERA Number: P02400001909
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Tower M update
Final coat (2nd) of external paint in progress. Works are also in progress for the main door polishing (above 19th floor), 2nd coat paint (completed up to 16th floor), basement & staircases (Kota stone) polishing, corridor final coat painting and lobby tiling polishing works are in progress. Electrical wiring till the 18th floor and CP & Sanitary fixing till the 16th floor are completed.
TS RERA Number: P02400000676
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Tower N update
Works are in progress for the Car Park Sheds while the Tot-lot area's water flooring works are completed.
Lakeside
Tower M
Tower N
TS RERA Number: P02400003490
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Lakeside Update
Structure completed till the 24th floor. Putty works are in progress on the 11th and 12th floors. While door frames fixing is completed up to the 15th floor, toilet dado & internal apartment tiling works are in progress on the 15th floor. The fire alarm and detection system conduit laying works on the 22nd floor are in progress.
TS RERA Number: P02400001909
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Tower M update
Final coat of external paint in progress. Floor tiling completed till the 19th floor and works are also in progress for the main door polishing (above 10th floor), corridor acid wash & 2nd coat paint (completed up to 14th floor), staircase-1 Kota stone polishing (in progress on the 17th floor), switch boards fixing and CP & Sanitary fixing (15th floor in progress). Tower entrance flagstone laying works are completed.
TS RERA Number: P02400000676
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Tower N update
Works are in progress for the Car Park Sheds. Tot-lot granite flooring works including play equipment installation is complete.
Lakeside
Common Area
TS RERA Number: P02400003490
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Lakeside Update
Structure completed till the 22nd floor while on this floor the fire alarm and detection system conduit laying works are in progress. Putty works are in progress on the 9th floor, staircase railings are completed till the 10th floor, toilet dado & tiling works are in progress on the 12th & 13th floors while door frames fixing is in progress on the 14th & 15th floors.
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Common Area Update
Towers Podium East Side VDF and Skylights works completed while work is in progress on the Car Park Sheds. Specifically for Tower M, the Landscaping works are in progress and for Tower N, the East Side Podium fabrication and tot-lots works are in progress.
Tower M
Lakeside
TS RERA Number: P02400001909
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Tower M update
Terrace waterproofing works are in progress with final ponding going on. Corridor Acid wash & Deep cleaning is completed till the 8th floor. Deep cleaning of the 10th floor is in progress. Entrance Lobby Glazing works Completed
TS RERA Number: P02400003490
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Lakeside Update
20th floor slab Completed and the 21st floor walls in progress. Podium excavation & footings' PCC works in progress
Tower M
Lakeside
TS RERA Number: P02400001909
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Tower M update
Terrace works protection coating is in progress, the 3rd coat of paint completed till the 5th floor, Entrance Lobby Glazing works in progress, main door frames is in progress on the 19th floor and UPVC windows of the 19th floor is in progress and electrical wiring works on the 16th floor are in progress. Corridor's flooring is completed till the 15th floor and corridor's false ceiling is completed till the 18th floor.
TS RERA Number: P02400003490
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Lakeside Update
The slab till the 18th floor is completed. Pump room excavation and fire tank waterproofing works are in progress. For the corridors, flooring is completed till the 6th floor and putty till the 5th floor.
Lakeside
Tower N
Tower M
TS RERA Number: P02400003490
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Lakeside Update
The slab till the 16th floor is completed. Pump room excavation works are in progress. Balcony & Utility Railing works till the 13th floor are completed, putty works of the 3rd and 4th floors are in progress while flooring till the 4th floor is completed. For the corridors, flooring is completed till the 4th floor.
TS RERA Number: P02400000676
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Tower N update
After all works have been completed, podium VDF and Groove cutting works are also completed.
TS RERA Number: P02400001909
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Tower M update
Terrace works protection coating is in progress, the 2nd coat of putty for the 19th floor is in progress, main door shutting is in progress on the 13th floor and UPVC windows of the 15th floor is in progress and electrical wiring works on the 11th floor are in progress. Corridor's flooring is completed till the 14th floor and corridor's false ceiling is completed till the 17th floor. Staircase kota flooring works are completed till the terrace and the entrance lobby marble flooring works are completed.
Tower M
Tower N
Lakeside
TS RERA Number: P02400001909
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Tower M update
Terrace works are in progress. 2nd coat of putty for the 17th floor is in progress, waterproofing works for the toilets are completed till the 15th floor, sliding door fixing of the 9th floor is in progress and staircase works are completed till the 15th floor.
TS RERA Number: P02400000676
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Tower N update
All works are completed and de-snagging is in progress.
TS RERA Number: P02400003490
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Lakeside Update
The slab till the 13th floor is completed. Balcony & Utility Railing works till the 10th floor is completed and the East side Storm Water Drain raft casting works are completed. 14th floor slab conduit laying works are in progress.
Lakeside
Tower N
Tower M
TS RERA Number: P02400003490
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Lakeside Update
The slab till the 10th floor is completed. Balcony & Utility Railing works till the 4th floor is completed and the North and West side Storm Water Drain works are completed. 1st floor full welding works are in progress. 3rd floor fabrication works are in progress. Waterproofing of the South side retaining wall is completed.
TS RERA Number: P02400000676
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Tower N update
Final coat of paint, deep cleaning works and the main door polishing is completed till the 19th floor. CP, Sanitary, Switch board installation works are completed till the 19th floor and the corridor light fixtures are being fitted. Final polishing works of the Entrance Lobby's Italian Marble are in progress. Landscaping works are completed.
TS RERA Number: P02400001909
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Tower M update
Parapet and elevation Wall works are completed. Plastering of the 19th floor is in progress and terrace works are in progress. PPR lining works on the 19th floor are in progress. Sliding door fixing of the 5th floor is in progress and waterproofing works for the toilets are completed till the 15th floor.
Lakeside
Tower N
Tower M
TS RERA Number: P02400003490
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Lakeside Update
The slab till the 8th floor is completed and Waterproofing works for the 2nd & 3rd floors are in progress. Putty works for the 2nd floor are in progress and the west side drain raft of the basement works are in progress.
TS RERA Number: P02400000676
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Tower N update
External final coat of print for all 57 faces is complete, the 2nd Coat is completed till the 19th Floor. Terrace waterproofing, HT wiring and lifts (service and passenger) are all completed. | CP, Sanitary, Switch board installation works are completed till the 17th floor and the main door polishing is completed till the 15th floor. | Podium and car parking works are in progress while the basement works are almost completed.
TS RERA Number: P02400001909
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Tower M update
Elevation Wall works are in progress, 2nd coat of paint of the 1st floor is completed, block work and the staircase railing works for the 19th floor is in progress. | Plastering of the 16th and 17th floors and structure (floor slab) for the 19th floor is completed. Terrace works are in progress while the OHT slab casting is completed and corridor flooring of the 6th floor is completed. | Door frames fixing for the 12th floor are in progress, sliding door fixing of the 4th floor is completed, Vitrified Flooring Works till the 11th floor is completed and waterproofing works for the toilets are completed till the 13th floor and Windows fixing of the 7th floor is in progress.
Tower N
Tower M
Lakeside
TS RERA Number: P02400000676
* These are randomly clicked pictures of work in progress from preceding month. Not to be considered as progress in entirety.
Tower N update
Tower interior works like entrance lobby glazing, stone works, putty, paint, vitrified tile flooring, main door shutters, CP, sanitary, switch board installation, including all deep cleaning etc. are all works in progress. Terrace works like Waterproofing and solar panel fixing are complete. Tower external work of the final coat of paint is almost completed. For further details, please contact our Customer Service Manager.
